NASA’s $500M Stage Adapter After 13 Years Justifies Cancellations

▼ Summary
– NASA is pivoting from building a lunar orbit space station to a surface base, and ending development of a new upper stage for the Space Launch System rocket.
– Contractors criticized the cancellations as walking away from nearly complete hardware needed for the Artemis Program.
– NASA Administrator Jared Isaacman argued the programs were not essential, had far exceeded budgets, and faced years of delays.

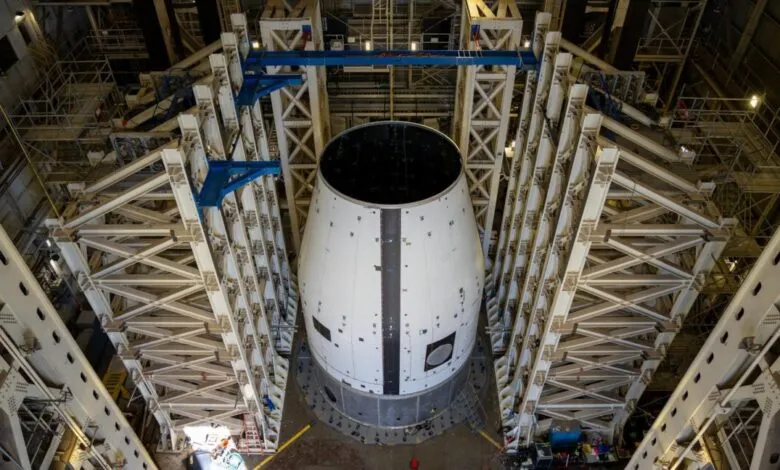

– The canceled elements include the Exploration Upper Stage, Universal Stage Adapter, Mobile Launcher 2, and Habitation and Logistics Outpost.
– An inspector general report found combined contract values for these efforts ballooned from $2.8 billion to $5.9 billion, with delivery delays of up to seven years.
Three months ago, NASA Administrator Jared Isaacman announced a dramatic shift in the agency’s lunar strategy: instead of building a space station in orbit around the Moon, NASA would focus on establishing a base on the lunar surface. Dubbed the “Ignition” event, this pivot followed an earlier decision to halt development of a new upper stage for the Space Launch System (SLS) rocket.
In the wake of these announcements, some critics,mainly contractors tied to the affected programs,grumbled that NASA was foolishly abandoning nearly finished hardware essential to the Artemis Program. Isaacman pushed back, arguing that these projects were not critical for landing humans on the Moon. He noted they had ballooned far beyond original budgets, suffered years of delays, and still weren’t ready for prime time.
“For too long we tried to satisfy every stakeholder,” Isaacman said during the March Ignition event. “Billions of dollars wasted. Years lost. Hardware that never launched. Fewer flagship science missions. And fewer astronauts in space, which means fewer kids dressing up as astronauts for Halloween. I don’t like it. The president doesn’t like it. The American people have waited long enough.”
On Wednesday, NASA’s Office of the Inspector General released a memorandum reviewing the canceled Artemis elements. The list includes the Exploration Upper Stage (an SLS upgrade), the Universal Stage Adapter (connecting Orion to that stage), Mobile Launcher 2 (a larger launch tower), and the Habitation and Logistics Outpost (a habitation module for the Lunar Gateway).
The inspector general’s report paints a stark picture: “Over the course of their life cycles, the combined contract values for these efforts ballooned from nearly $2.8 billion to $5.9 billion and NASA extended their contracted delivery dates by up to seven years.” The report adds that if work had continued to completion, the systems would have cost even more and taken even longer than already agreed upon.
In short, the numbers justify the cancellations. After 13 years and a half-billion dollars spent on the stage adapter alone, NASA’s decision to cut losses and refocus on a surface base appears not just pragmatic, but overdue.
(Source: Ars Technica)
